Restoring the Historic Chickasaw Nation Boarding School

Established in 1854 near the banks of the Red River in a small town called Lebanon, Okla., sat an abandoned, two-story brick structure. It once served as a boarding school for Chickasaw Nation girls, an orphanage, then as a manual labor school where Chickasaw children learned agriculture, horticulture, homemaking, sewing, knitting, cooking and housekeeping. Steeped in Chickasaw history, the structure, named the Burney Institute, had fallen into disrepair when it was abandoned some time after 1910.

In 2014—15, Chickasaw Nation officials funded a complete restoration of the historic landmark for possible use as a museum. Western Specialty Contractors — Dallas, Texas branch was hired to tuckpoint the structure’s entire brick facade, as well as rebuild interior and exterior brick walls and corners, and provide structural anchoring at the cracks.

Restoration of the building’s exterior was a challenge for Western’s crews in terms of specifying modern materials that were compatible with materials used in the original construction. It was discovered that fine sands from the nearby Red River were used to make the original mortar and the bricks themselves. Western used modern technology to determine the best mortar mix for the job.

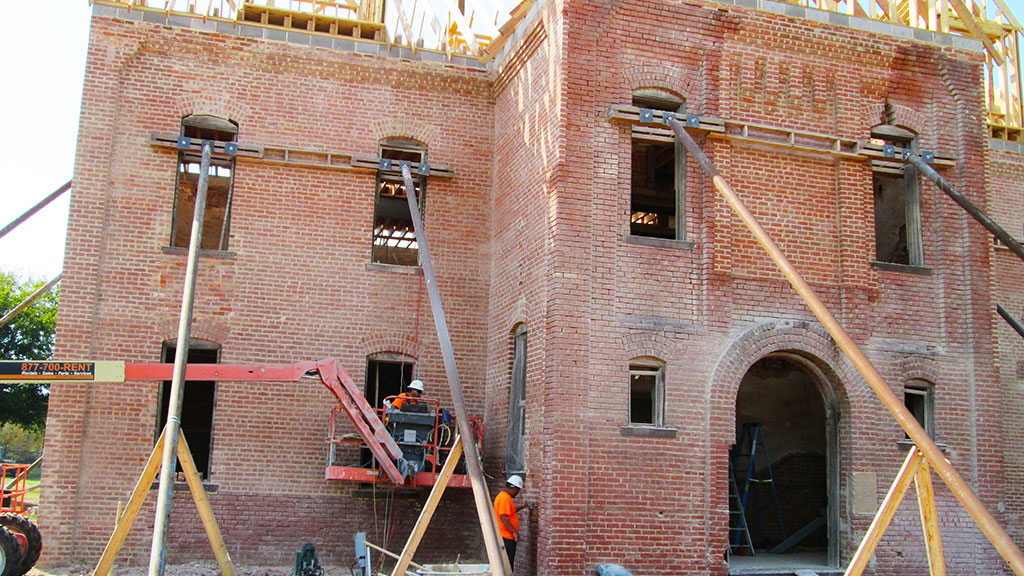

The Burney Institute during restoration.
The Burney Institute during restoration.
“We sent the mortar to a testing facility in Iowa to determine its exact makeup,” said Dallas branch manager Ben Grandbois. “Once we knew what it was made out of, we worked closely with a concrete and mortar company and the architect to find the most compatible material to use. We ended up using a Type O mortar as a match.”

Due to a limited supply of bricks, Western crews got creative and used salvaged bricks from the building’s interior walls to match the existing exterior facade, as well as bricks taken from footings beneath the main floor that were replaced with structural steel supports.

Multiple cracks toward the bottom of the building, caused by more than 100 years of ground settling, were also repaired using helical anchors set into epoxy at angles to stitch the cracks prior to any wall repairs. Using an IBIX grout pump allowed Western crews to increase production on the massive tuckpointing job by 200 percent.

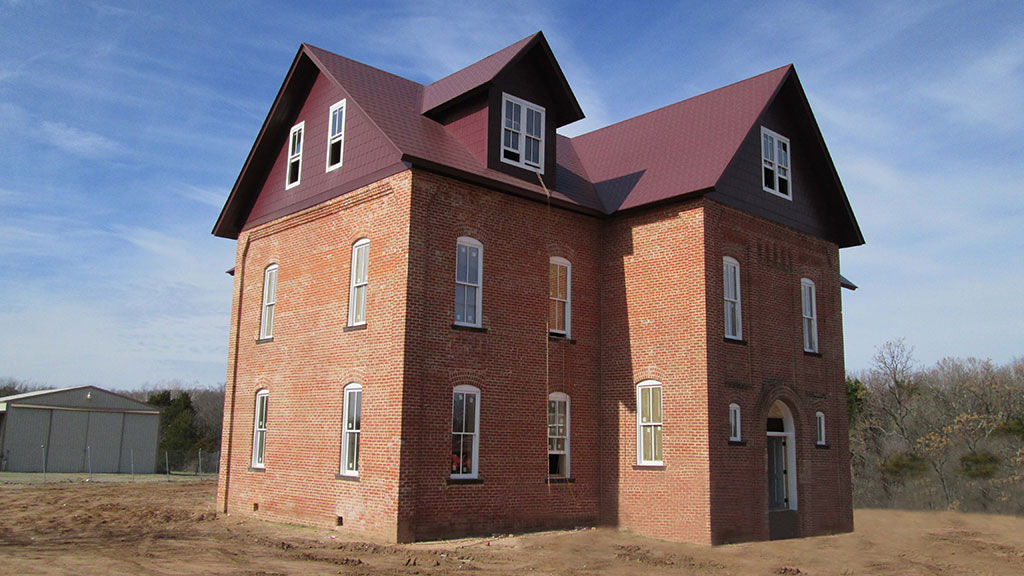

The Burney Institute after the restoration work.
The Burney Institute after the restoration work.
Experience and a little ingenuity by Western enabled crews to create the ever-so-slight concave finish on the mortar joints to match the building’s original finish.

“The finish of the original mortar joints did not allow for the typical striking we see most commonly today,” said Grandbois. “In order to maintain the historical significance and receive approval from the Chickasaw Nation, we performed many different mock-ups. Having a very seasoned foreman on the job helped tremendously as we tried many unique approaches. We eventually settled with a flush struck joint, followed by a light rake when the mortar had cured to an exact hardness.”

Western was able to complete the project within 14 months, on time and within budget.
2025 Masonry Milestones
March 2026

Take a look back at 2025 to see the MCAA’s biggest achievements and most memorable events!

MASONRY STRONG Podcast, Episode 38 Recap: Bob Thomas, CEO of the CMHA
March 2026

On this episode of the MASONRY STRONG Podcast, Justin got to talk with Bob Thomas about his vision with CMHA, how he sees it growing, and where he thinks this industry is heading in the future.

The 2026 MCAA Annual Online Auction
March 2026

The Mason Contractors Association of America is thrilled to announce the 2026 Annual Online Auction, the masonry industry’s premier event for scoring the best equipment at a fraction of costs. Whether you are looking to expand your equipment stockpile or

Brickworks Supply Centers Invite Masons to Register for New “Masons First” Program to Transform Transactional Relationships into Indispensable Partnerships.
March 2026
